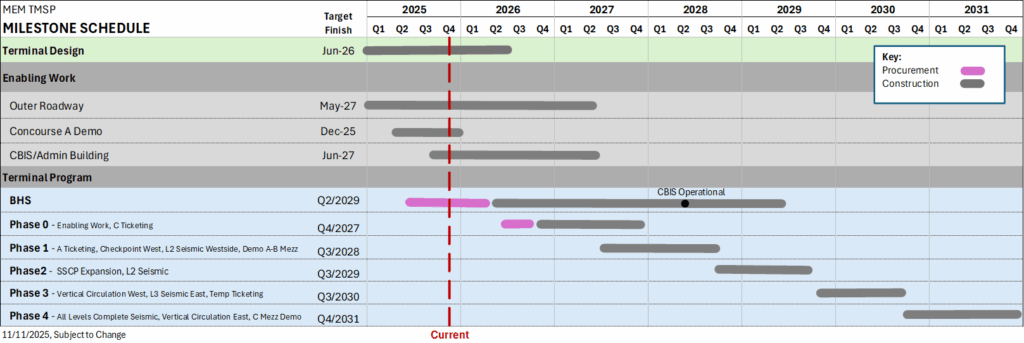

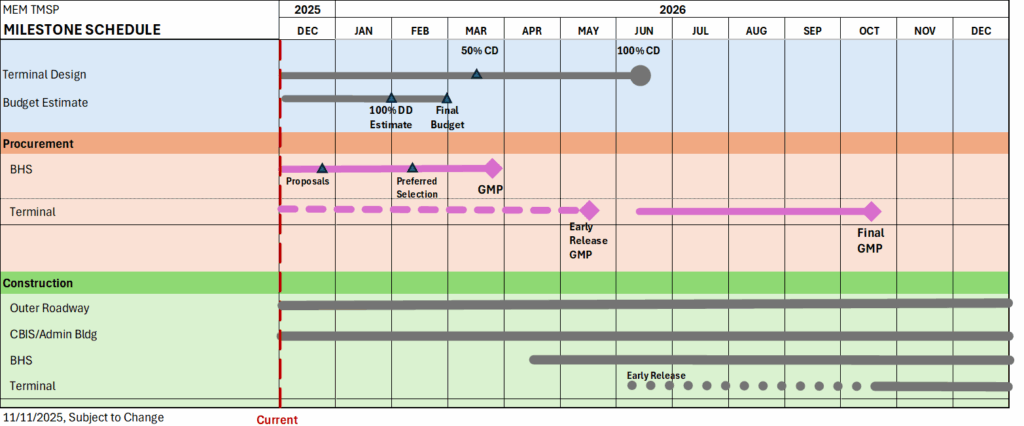

TMSP Project Milestones
| B Pedestrian Tunnel Reopens | Q3-2026 |
| Outer Roadway Substantial Completion | Q2/Q3-2027 |
| Concourse A Demolition Substantial Completion | Q2-2026 |
| Administration Building Steel Erection Begins | Q2-2026 |
| Administration Building Structure Complete | Q3-2026 |
| Administration Building Substantial Completion | Q2/Q3-2027 |
Phasing Overview
Our objective is to develop the best phasing strategy that aligns design and construction with:
• Safety
• Passenger flows and wayfinding
• Baggage handling/processing
• Airline operations
• Tenant impacts
The Design and Construction Team developed and evaluated numerous phasing plans over the last several months.
The current plan, while a work-in-progress, provides the basic elements of each major phase.
5 Major Phases

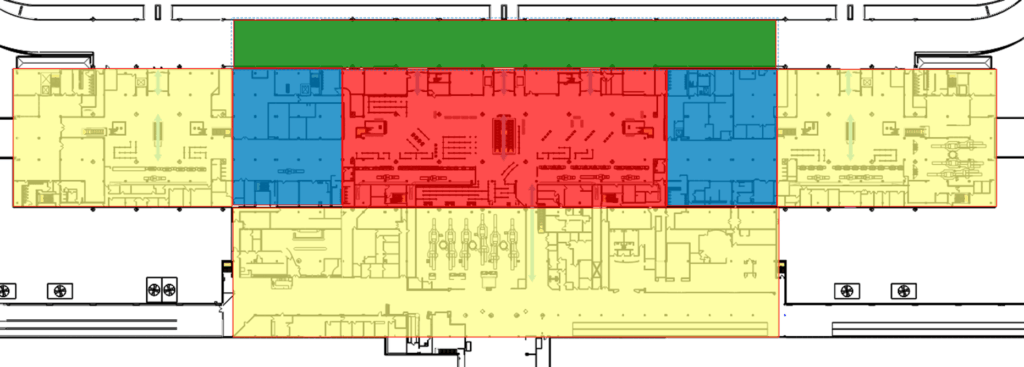

7 Areas

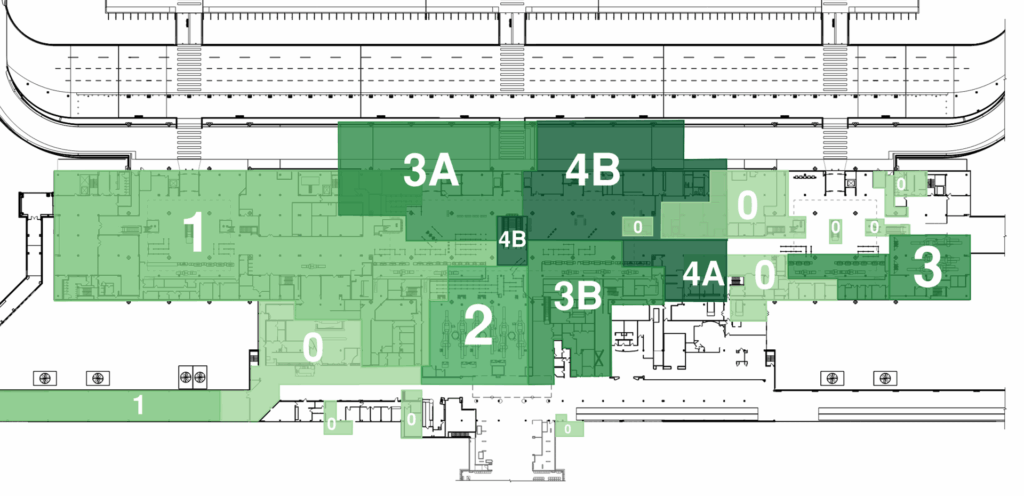

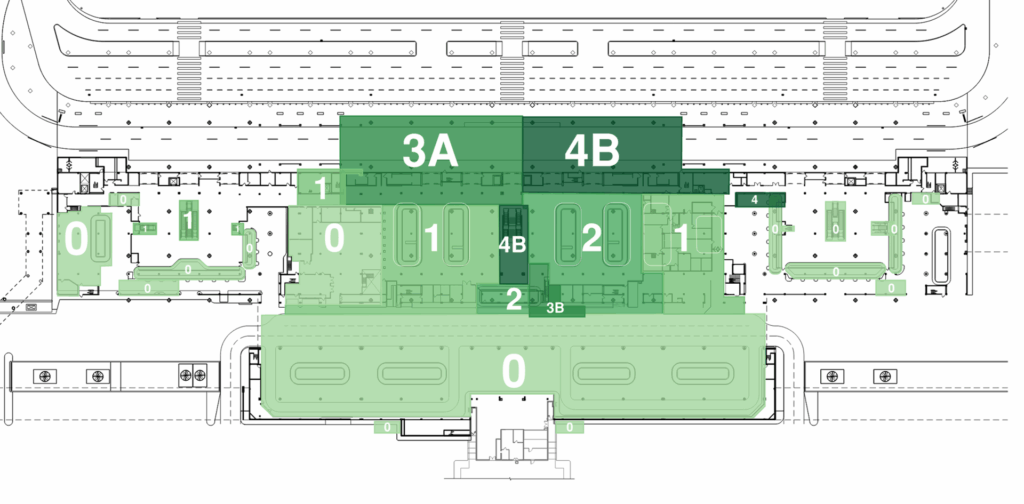

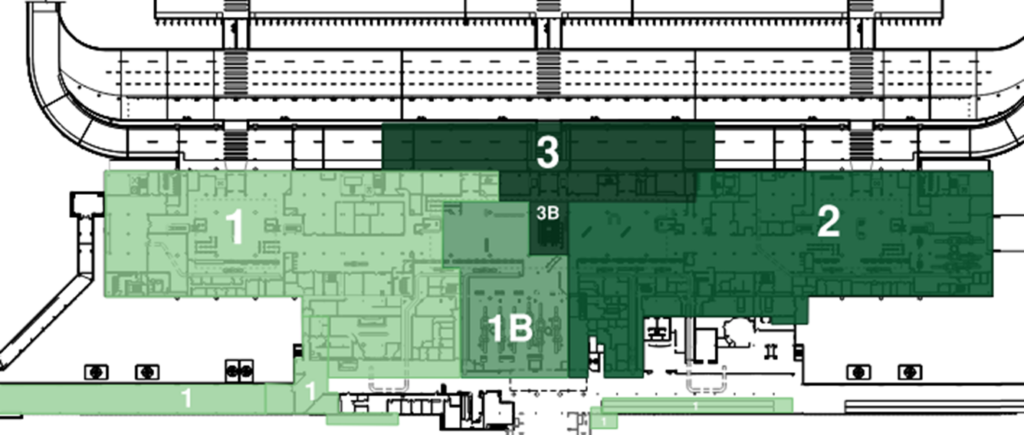

Overall Phasing Plan
Plaza/Basement Level

Baggage Claim / Arrivals Level

Ticketing Lobby / Departures Level

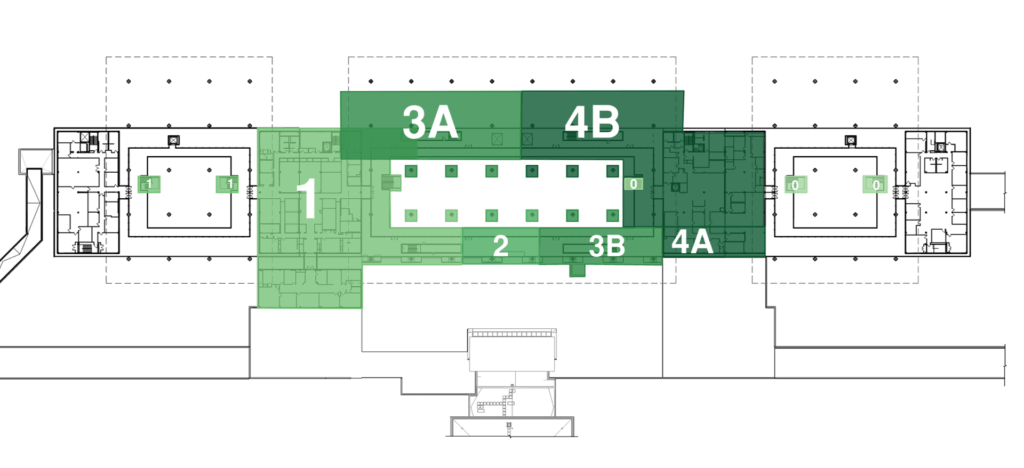

Mezzanine Level

Roof Level

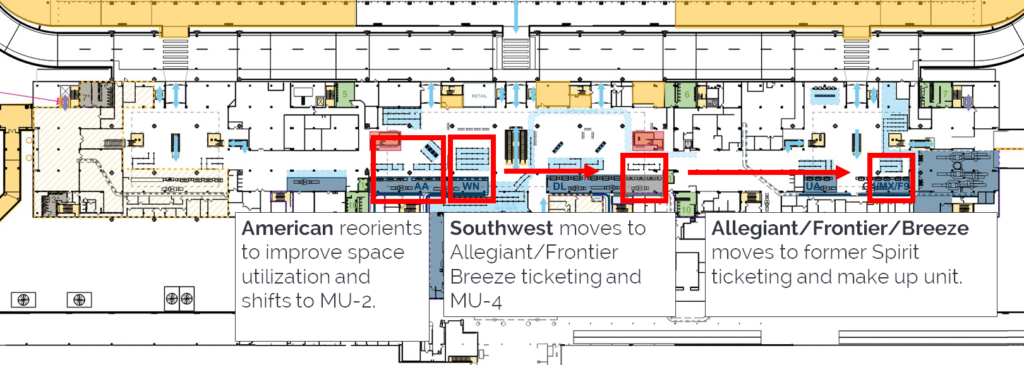

Enabling Phase

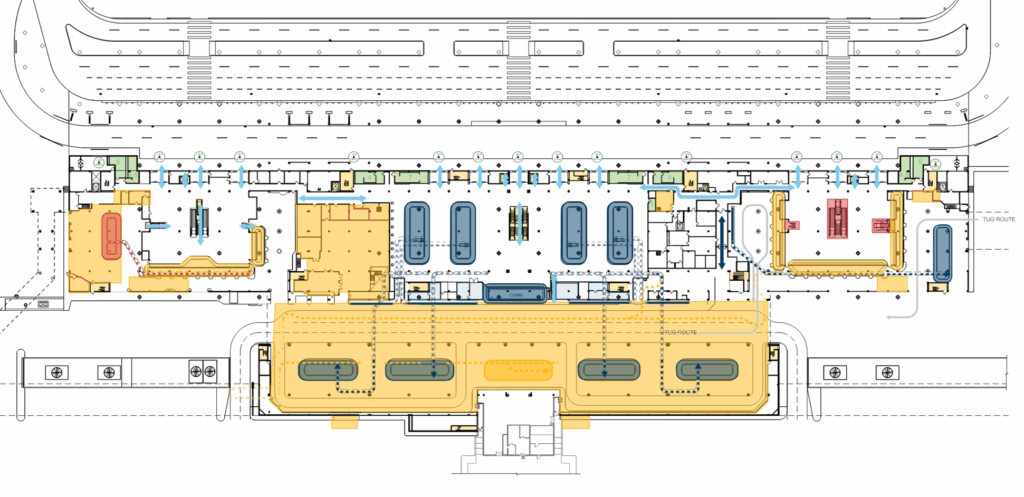

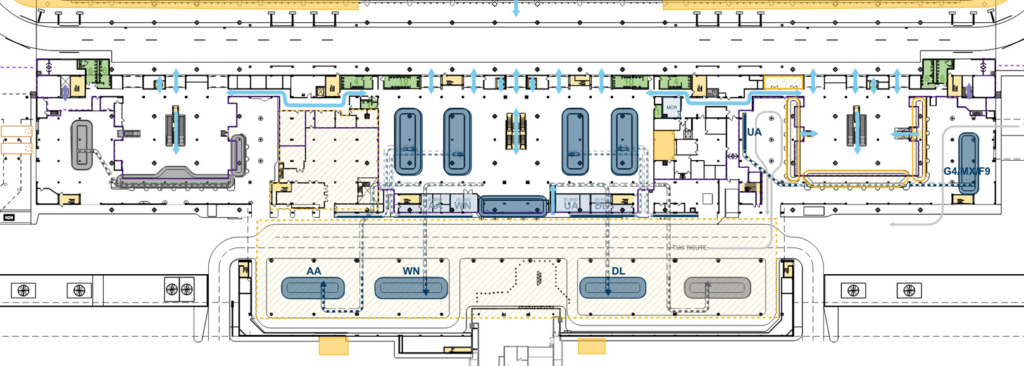

Baggage Claim / Arrivals Level
Gold-colored areas indicate construction zones.

Ticketing Lobby / Departures Level

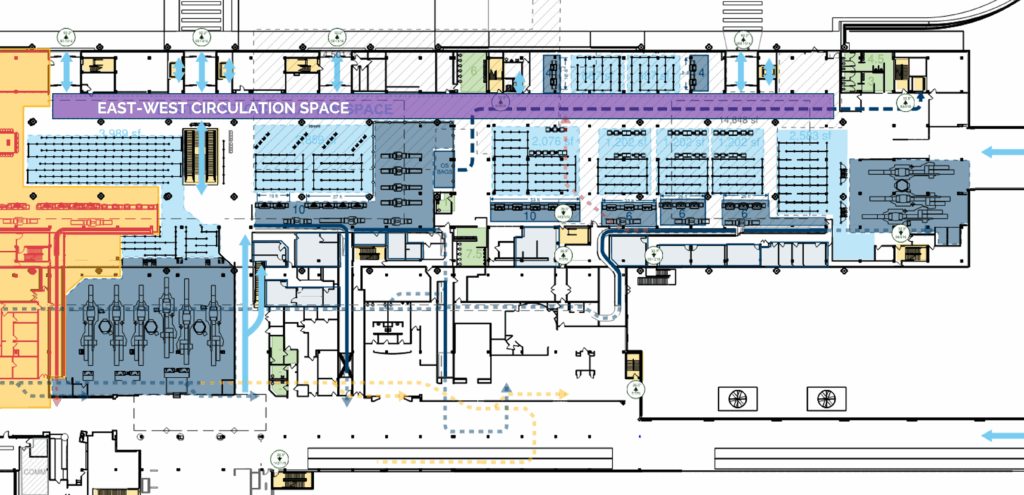

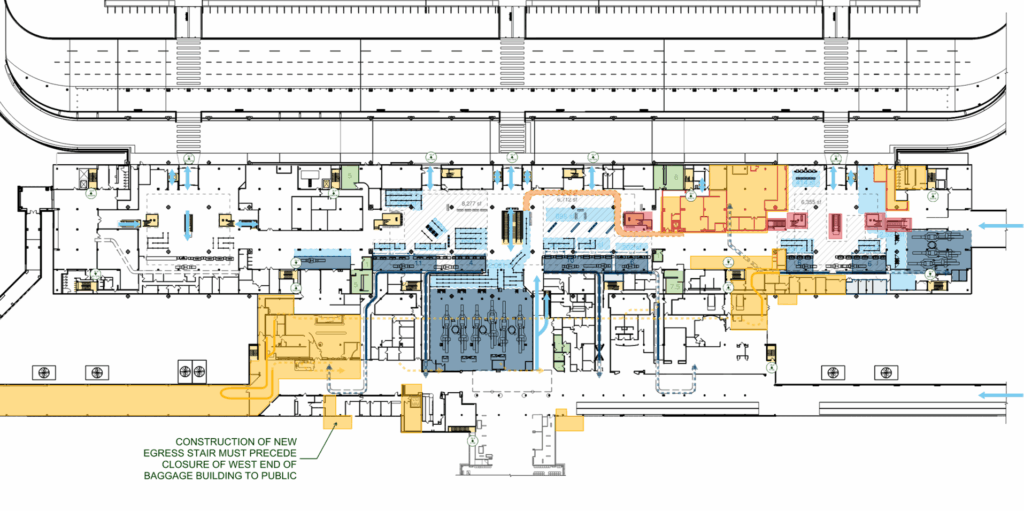

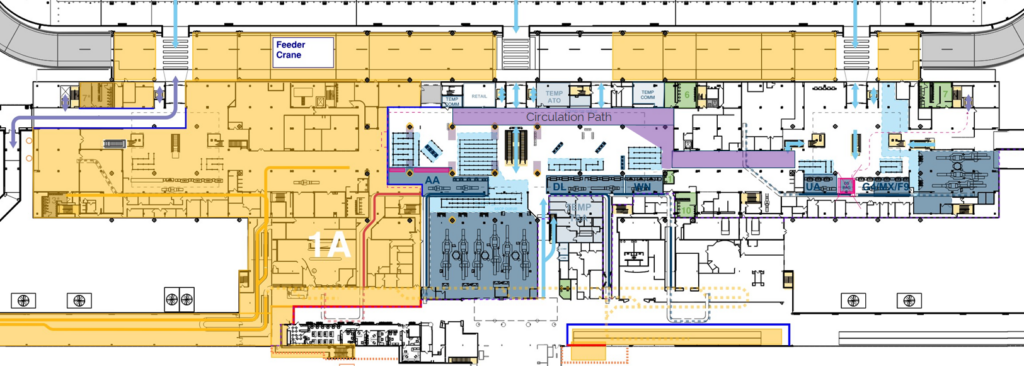

Phase 1A

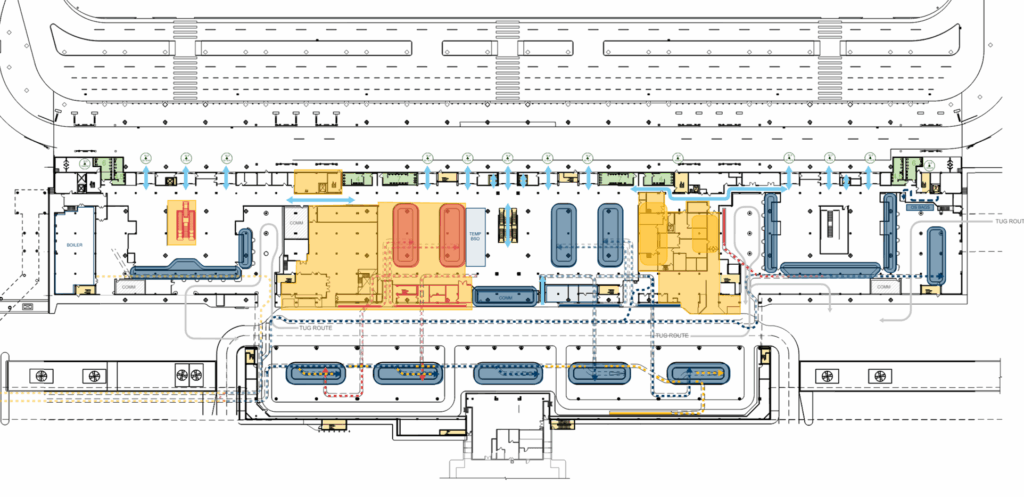

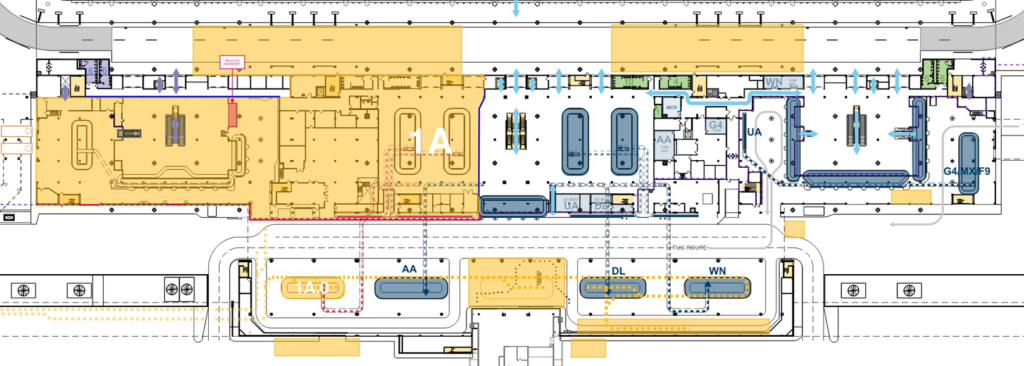

Baggage Claim / Arrivals Level

Ticketing Lobby / Departures Level

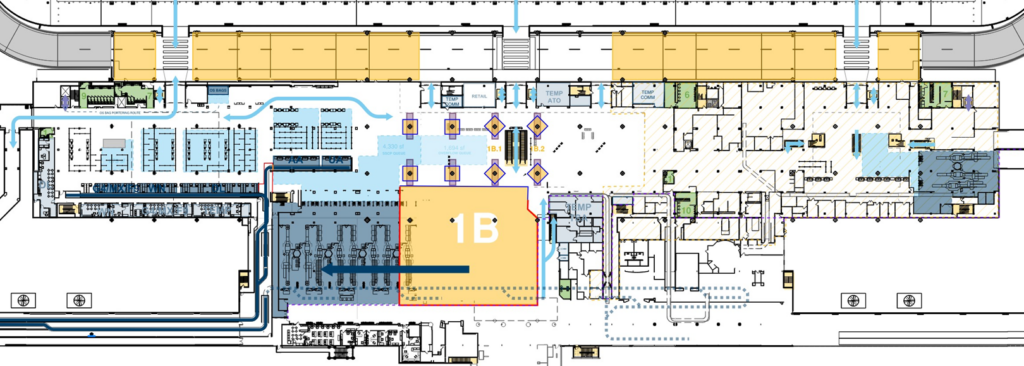

Phase 1B

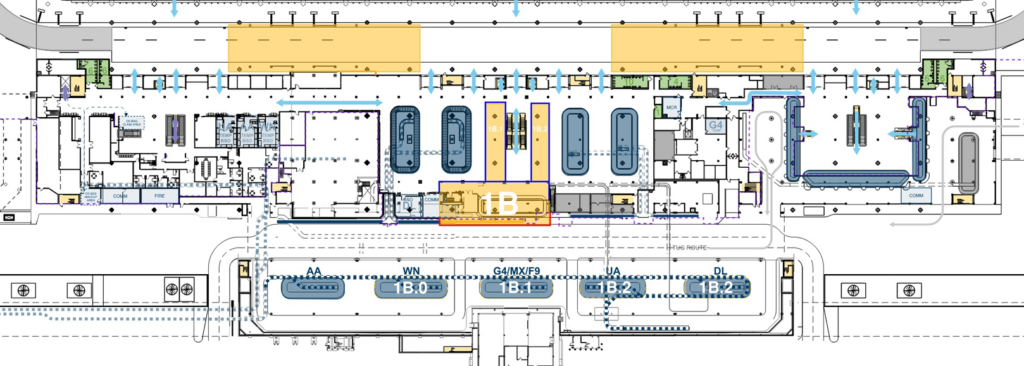

Baggage Claim / Arrivals Level

Ticketing Lobby / Departures Level

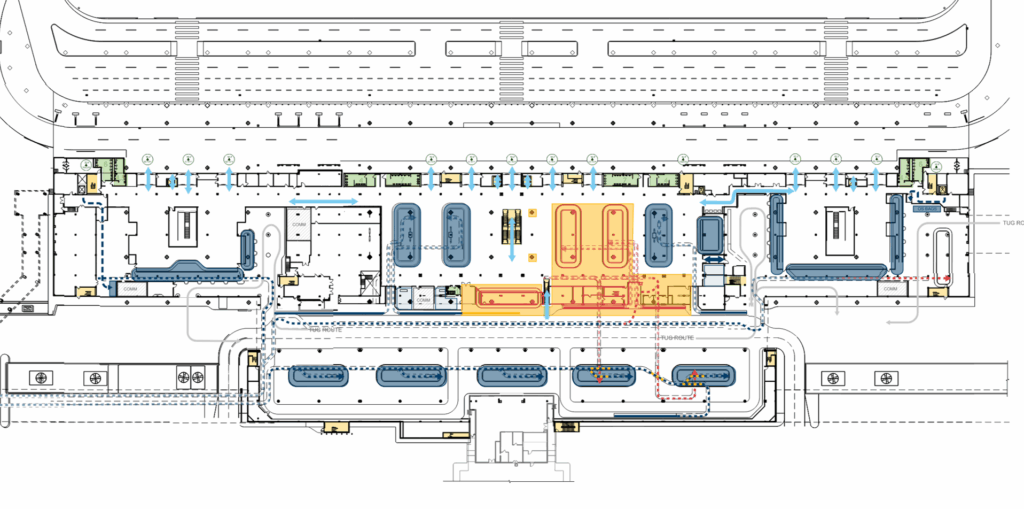

Phase 2A

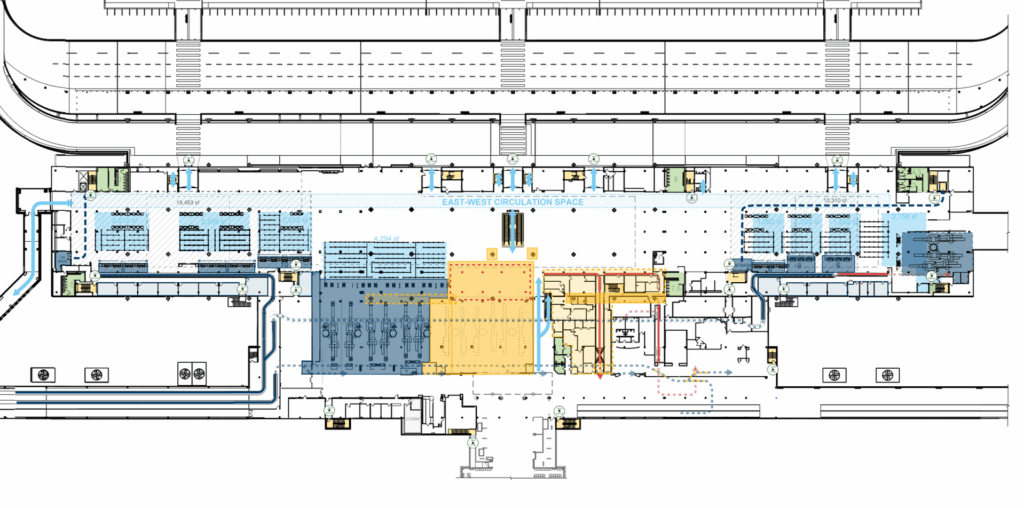

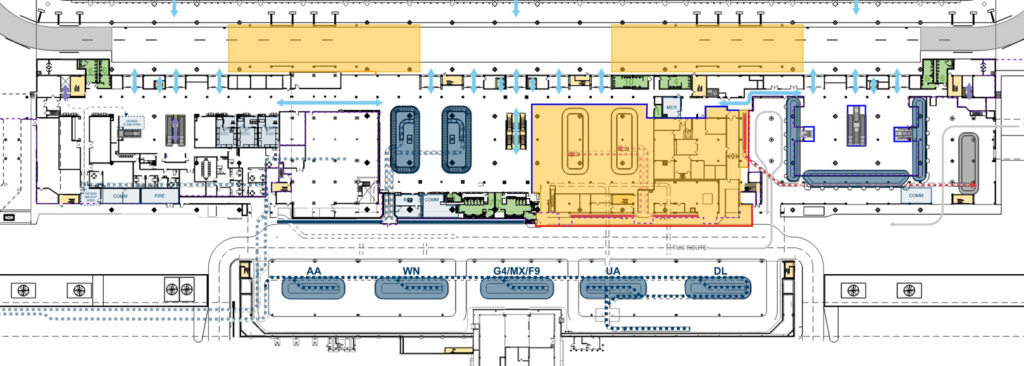

Baggage Claim / Arrivals Level

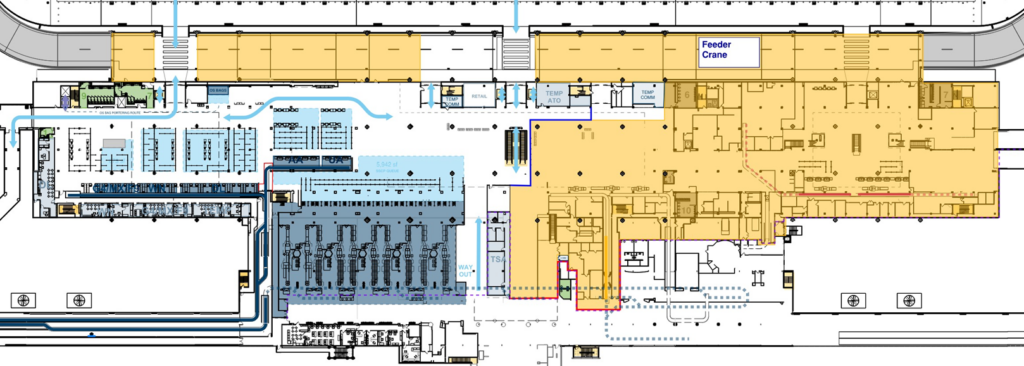

Ticketing Lobby / Departures Level

Phase 2B

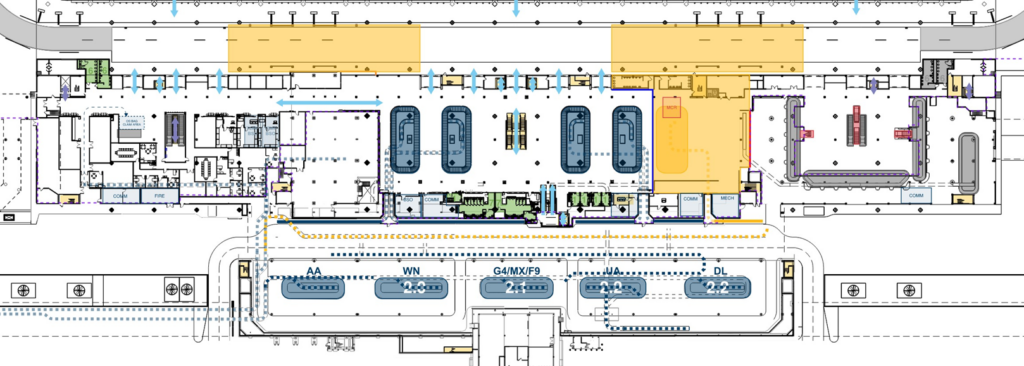

Baggage Claim / Arrivals Level

Ticketing Lobby / Departures Level

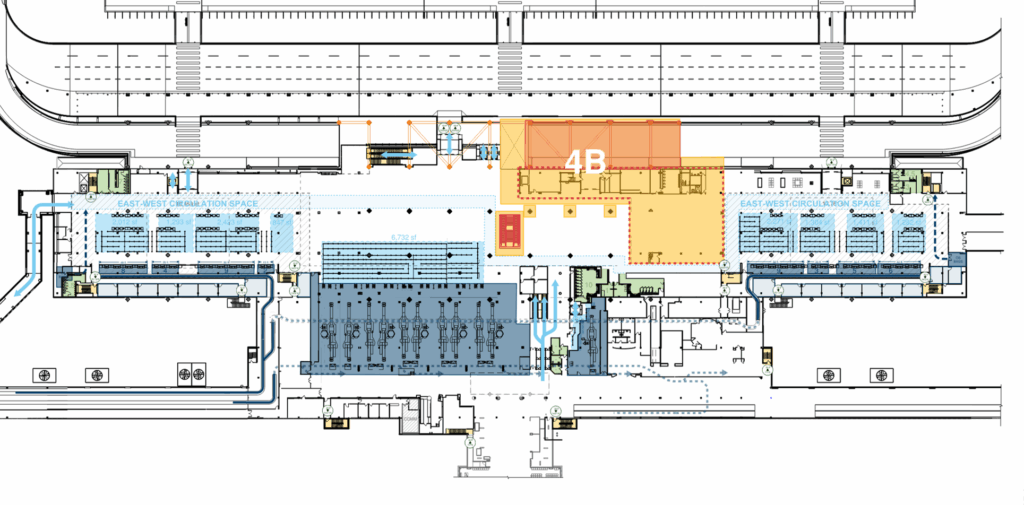

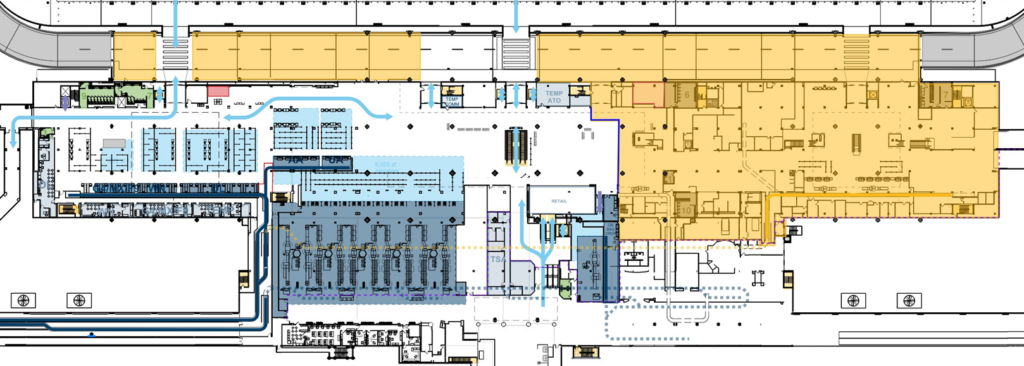

Phase 2B
Baggage Claim / Arrivals Level

Ticketing Lobby / Departures Level

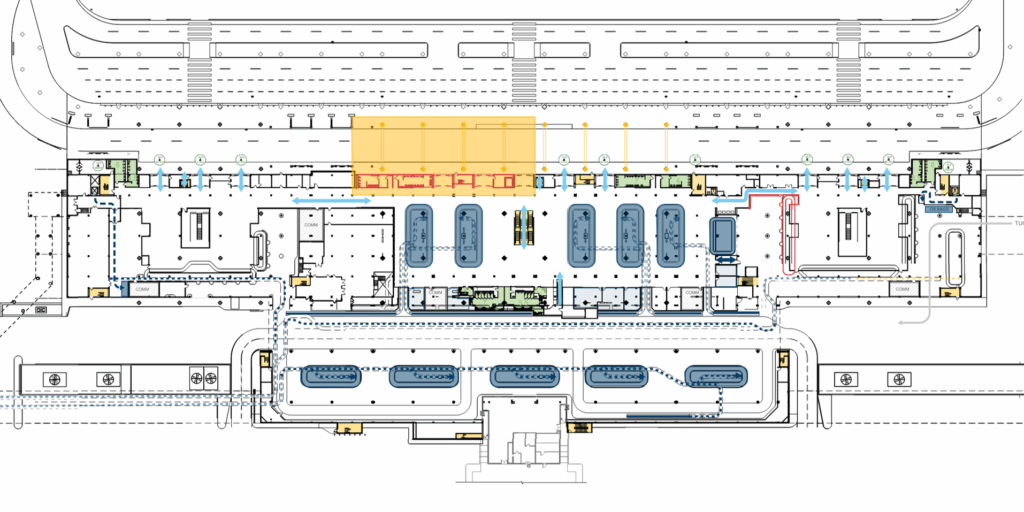

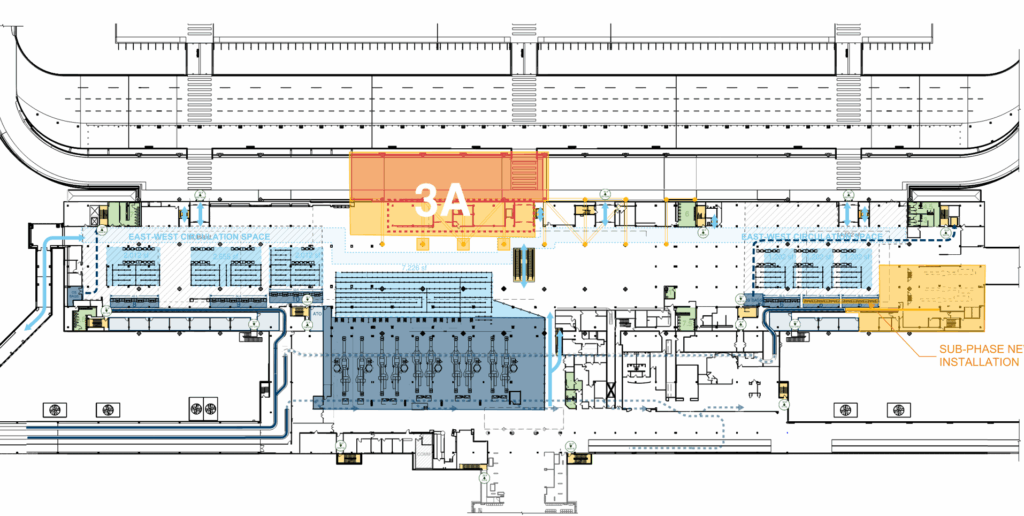

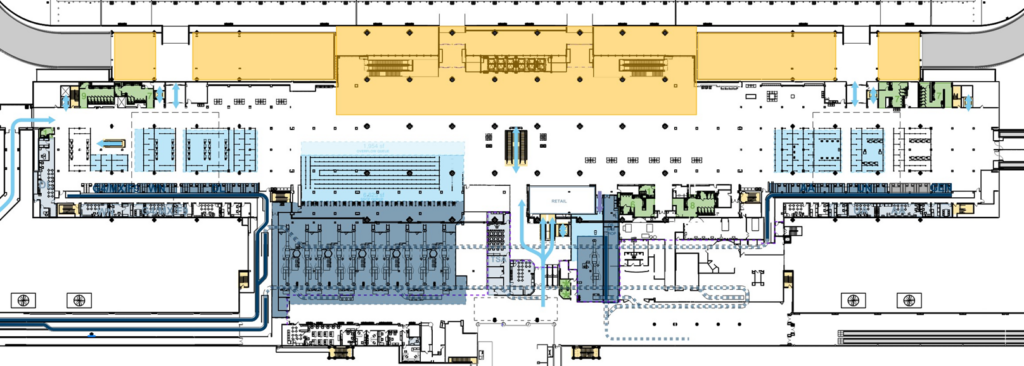

Phase 3A

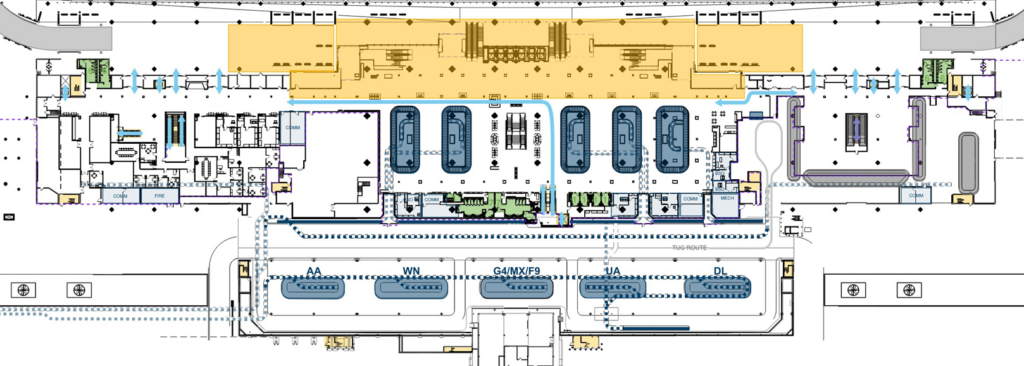

Baggage Claim / Arrivals Level

Ticketing Lobby / Departures Level

Phase 3B

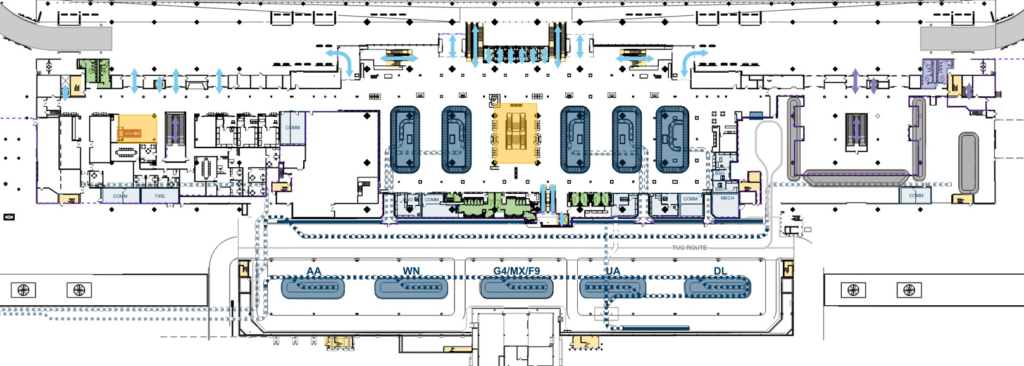

Baggage Claim / Arrivals Level

Ticketing Lobby / Departures Level

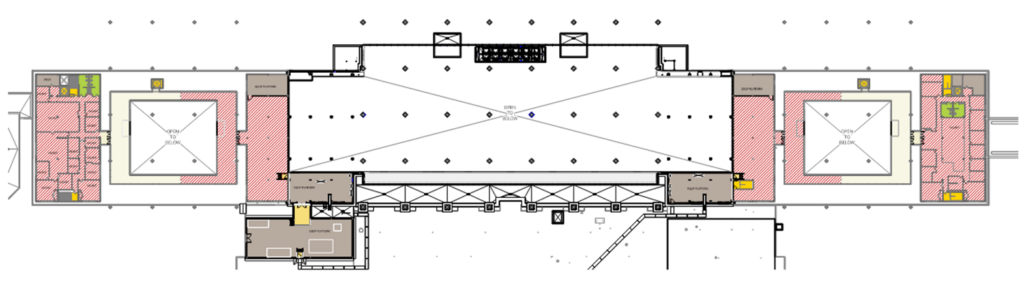

End State

Plaza / Lower Level

Baggage Claim / Arrivals Level

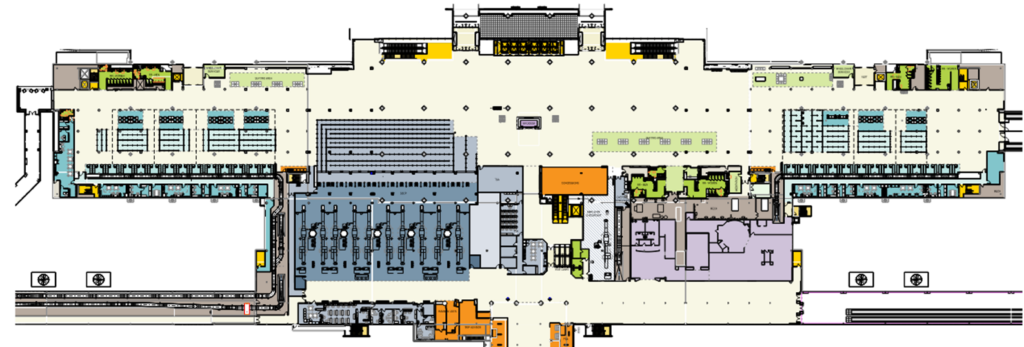

Ticketing Lobby / Departures Level

Mezzanine Level
